Snow plow route planning is the strategic process of designing prioritized, continuous paths that cover all necessary road segments while minimizing non-productive travel. Understanding how snow plow routes are planned separates reactive operations from reliable ones. The best plans use GIS mapping, GPS tracking, and American Public Works Association (APWA) priority tiers to sequence coverage from arterials down to residential streets. Contractors and municipal planners who apply these methods reduce fuel waste, cut salt overuse, and meet clearance time commitments even during multi-day storm events.

How are snow plow routes planned and prioritized?

Route planning starts with dividing the entire service area into logical zones based on road function and public safety impact. This segmentation is the foundation of every effective snow plow route planning guide.

The three standard priority tiers work as follows:

  1. Tier 1: Arterials. Major roads, highways, emergency access corridors, and bus routes receive the first pass. These roads carry the highest traffic volume and pose the greatest safety risk when left uncleared. Planners assign the most capable equipment here and set the tightest clearance time targets.

  2. Tier 2: Collectors. Secondary roads connecting arterials to neighborhoods fall into this category. They receive attention after arterials are passable. Clearance targets for collectors typically run one to two hours behind Tier 1 completion.

  3. Tier 3: Residential streets. Cul-de-sacs, local access roads, and low-volume streets receive the final pass. Planners often assign smaller trucks or loop routes here to handle tight turns and parked cars efficiently.

The rationale behind this sequence is straightforward: critical infrastructure must function first. Emergency vehicles, transit, and commercial freight cannot wait for residential streets to clear. Sequencing by tier protects public safety and reduces liability exposure for municipalities and contractors alike.

Minimizing deadheading, which is the non-productive travel a truck makes without its plow down, is the second major design goal. Continuous path design reduces deadheading by 10–15%, according to route optimization research. That reduction translates directly into lower fuel costs and faster coverage. Planners achieve this by designing routes that flow from one tier into the next without requiring trucks to backtrack across already-cleared roads.

Snow plow truck clearing snowy city street at dawn

Shared-boundary roads present a specific challenge. Assigning those segments to a single truck with a defined handoff point prevents duplication and guarantees complete coverage without overlap. This boundary discipline is one of the most overlooked details in manual route design.

What role does technology play in snow plow route optimization?

Technology has changed how planners build and refine routes. The shift from paper maps to GIS-based digital mapping is the single biggest structural improvement in the field.

Key tools and their functions include:

  • GIS mapping. Geographic Information Systems let planners visualize every road segment, assign tier classifications, calculate lane miles, and identify geographic constraints like dead ends and steep grades before a storm arrives.
  • GPS tracking. Real-time vehicle tracking shows supervisors exactly where each truck is and whether it has deviated from its assigned path. Historical GPS data reviewed each season reveals coverage gaps and route overlaps, giving planners concrete evidence for adjustments before the next winter.
  • Spreader controller integration. Linking spreader controllers to GPS units creates a real-time audit trail of material application rates. Spreader controller data prevents the unsafe default of applying salt at maximum rate regardless of road conditions. It also supports post-storm reporting for compliance and cost tracking.
  • Pre-wetting systems. Applying liquid brine to dry salt before it leaves the spreader improves adhesion to road surfaces. Pre-wetting salt reduces material usage by up to 30%. That reduction cuts costs and lowers the environmental impact of salt runoff on waterways and vegetation.
  • Turn-by-turn in-cab navigation. Digital GPS navigation is the biggest single factor in reducing deadheading and normalizing salt application rates. Drivers follow a verified sequence rather than relying on memory, which is especially valuable when substitute drivers cover unfamiliar routes.

Pro Tip: Run a seasonal post-storm review using GPS playback data. Identify the three segments with the longest clearance delays and redesign those micro-routes before the next season begins. Small fixes compound into major efficiency gains over a full winter.

Technology also supports turn-penalty modeling, which accounts for the time lost at difficult intersections, U-turns, and dead-end turnarounds. Routes that ignore turn penalties consistently underestimate completion times. Planners who build turn costs into their models produce schedules that drivers can actually meet.

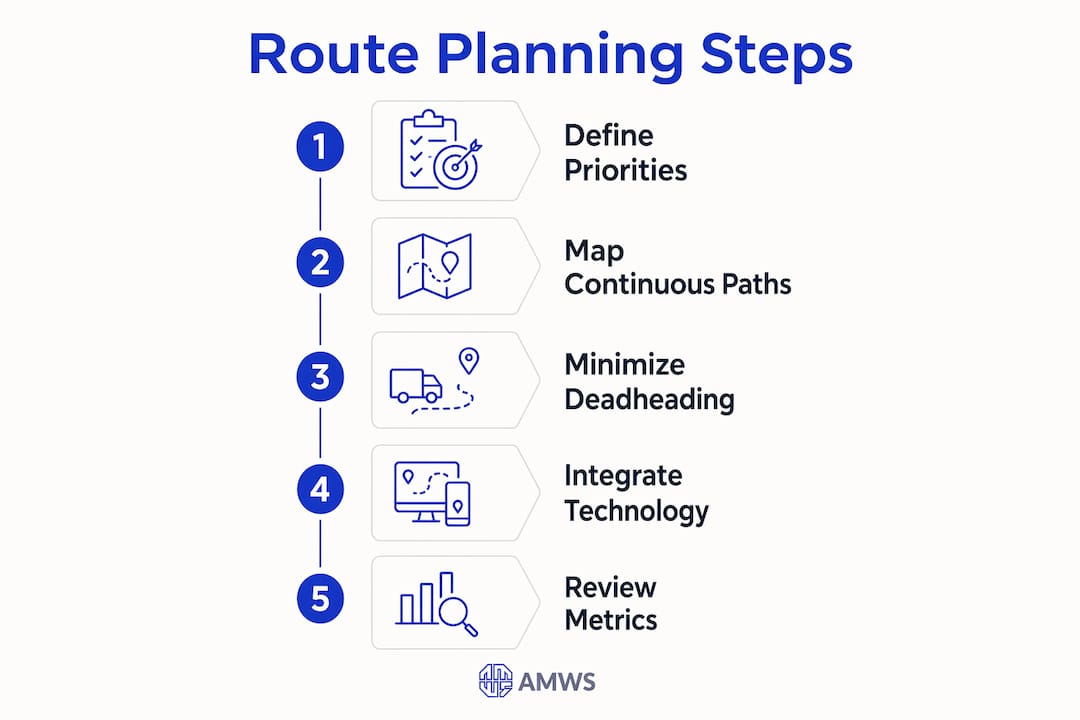

Infographic showing five key snow plow route planning steps

How do operational metrics and human factors shape route design?

Measuring the right things determines whether a route plan improves over time or stagnates. Effective route measurement tracks four key metrics: clearance time by priority tier, deadheading percentage, fuel consumption per lane mile, and resident complaint mapping. Speed alone is not a reliable indicator of quality.

Complaint mapping deserves special attention. When complaints cluster around specific intersections or street segments season after season, that pattern signals a structural problem in the route design, not just a one-time driver error. Planners who map complaints geographically can pinpoint and fix those weak spots directly.

Human factors are equally consequential. The APWA highlights the emotional impact on staff when organizations transition from legacy routes to optimized ones. Drivers who have run the same route for years often feel that optimization implies their past performance was inadequate. That perception, if unaddressed, creates resistance that undermines even the best technical plan.

Best practices for managing the human side of route changes include:

  • Involve drivers early. Drivers know their routes better than any planner. Their input on dead ends, tight turns, and problem intersections improves the final design.
  • Communicate the “why” clearly. Explain that optimization targets system efficiency, not individual performance. Use data to show drivers how the new route reduces their own workload.
  • Document every route in writing. Written route sheets and digital navigation files eliminate ambiguity. Route documentation protects both the organization and the driver when disputes arise.
  • Build buffer time into every route. A 10–15% buffer added to planned route duration accounts for equipment breakdowns, traffic, and weather variability. Routes without buffer time fail regularly and erode driver confidence.

Municipal policy adds another layer of complexity. Most municipalities assign responsibility for snow pushed into driveway entrances to property owners, not the plow contractor. Communicating that policy clearly before winter begins prevents complaints and disputes that consume planner time during storms.

Pro Tip: Hold a pre-season route walkthrough with drivers before the first snowfall. Walking or driving the route in dry conditions lets drivers flag problem spots and builds their confidence in the plan before conditions get harsh.

What are the best snow plowing strategies for multi-phase storm events?

Multi-phase storms require a different planning structure than single-pass events. The route design must accommodate three distinct operational cycles.

Phase Objective Key tactic
First pass Clear arterials and collectors to passable condition Deploy full fleet to Tier 1 and Tier 2 simultaneously
Maintenance pass Keep cleared roads open as snow accumulates Cycle trucks back through arterials while Tier 3 begins
Final cleanup Full clearance of all tiers including residential Consolidate equipment after storm ends for complete coverage

Staging salt and equipment is as important as the route sequence itself. Salt storage depots positioned at the geographic center of each route zone minimize reload travel time. Trucks that reload at the edge of their zone rather than returning to a central yard can complete an additional maintenance pass per shift during a heavy storm.

Side wings on plow trucks extend the effective plow width by half a lane. That added width means fewer passes per road corridor and faster overall clearance. Side wings are most effective on wide arterials and collector roads where lane width allows full deployment.

Coordinating multiple trucks on adjacent routes requires clear handoff boundaries. When two trucks work the same corridor from opposite ends, a defined meeting point prevents both overlap and gap. Planners assign those meeting points on the route map before the storm begins, not during it.

Multi-pass storm strategies that integrate salt staging and equipment positioning consistently outperform plans that treat each pass as a separate operation. The efficiency gain comes from treating the entire storm event as one coordinated sequence rather than a series of independent responses.

Key Takeaways

Effective snow plow route planning combines priority zone sequencing, continuous path design, and real-time technology to deliver consistent clearance times while controlling fuel and material costs.

Point Details
Priority tier sequencing Clear arterials first, then collectors, then residential streets to protect public safety.
Continuous path design Design routes that flow between tiers without backtracking to cut deadheading by 10–15%.
Technology integration Use GIS, GPS tracking, and spreader controllers to verify coverage and control salt use.
Human factor management Involve drivers in route design and communicate changes clearly to reduce resistance.
Multi-phase storm planning Stage salt depots and define truck handoff points before the storm begins, not during it.

What I’ve learned from watching route plans succeed and fail

Route optimization projects fail most often not because of bad data, but because planners treat the route as a math problem and ignore the people running it. I’ve seen technically excellent plans collapse in the first major storm because drivers reverted to their old paths the moment conditions got stressful. The plan lived in a spreadsheet. The drivers lived in their trucks.

The organizations that get this right do one thing differently: they treat the route review as a team event, not an internal planning exercise. They sit down with drivers before the season, show them the GPS playback from last year, and ask where the plan broke down. Drivers remember exactly which intersection caused a 20-minute delay in february. That knowledge never makes it into a GIS system on its own.

The other consistent failure point is ignoring buffer time. Planners who build routes to 100% capacity assume perfect conditions. A single equipment issue at hour two of a six-hour route cascades into missed clearance windows across the entire tier. A 10–15% buffer is not padding. It is the difference between a plan that holds under pressure and one that falls apart.

Pre-season preparation is where the real work happens. The storm is too late to fix a bad route. Every hour spent reviewing last season’s GPS data, adjusting zone boundaries, and briefing drivers in october pays back tenfold in january. The planners who treat summer as the snow season are the ones whose operations run cleanly when it matters.

— MOHAMED AWAD

AMWS Group’s approach to commercial snow removal

https://amwsgroup.com

AMWS Group provides commercial snow removal services built on the same priority zone and continuous path principles covered in this guide. The team uses real-time monitoring and pre-planned route structures to deliver consistent clearance times for commercial properties, regardless of storm intensity. Every client plan includes 24/7 emergency support and direct communication so you always know the status of your property during a storm event.

For facilities that need a single vendor managing snow, landscape, and maintenance, AMWS Group’s commercial maintenance services cover all three under one coordinated plan. Contact AMWS Group before the season starts to build a route plan tailored to your property’s specific layout and clearance requirements.

FAQ

How are snow plow routes divided into priority zones?

Routes are divided into Tier 1 arterials, Tier 2 collectors, and Tier 3 residential streets. Arterials receive the first pass because they carry emergency vehicles and high traffic volumes.

What is deadheading in snow plow route planning?

Deadheading is non-productive travel with the plow raised. Continuous path design reduces deadheading by 10–15%, cutting fuel costs and improving clearance speed.

How does GPS tracking improve route planning?

GPS tracking records actual truck paths and material application rates. Reviewing that data each season identifies coverage gaps and overlaps, giving planners specific evidence for route adjustments.

Why does pre-wetting salt matter for route efficiency?

Pre-wetting salt before application improves adhesion to road surfaces and reduces total material usage by up to 30%. That reduction lowers costs and decreases environmental runoff impact.

How much buffer time should a snow plow route include?

Route plans should include a 10–15% buffer above the estimated completion time. That buffer absorbs equipment breakdowns, traffic delays, and weather variability without causing clearance windows to be missed.
